Legacy System Migration Planning: How to Move Critical Operations Without Disrupting the Business

Nicholas Ng
Nicholas Ng
Founder of Virtualspirit, a tech guy who always want to step out his comfort zone and bringing more values to people
Legacy System Migration Planning for Critical Operations
World-class insights, delivered weekly.
By entering your email, you agree to receive updates from Virtualspirit.

Legacy migrations usually become risky long before cutover day. The warning signs appear in undocumented dependencies, inconsistent data, unrealistic downtime assumptions, and weak rollback planning. That is why safe migration planning is about continuity first and speed second.

Direct answer

The safest migration plan for a business-critical system focuses on continuity before speed: map dependencies early, triage data quality, choose the right cutover pattern, and define validation and rollback before go-live.

Why critical migrations fail

Many migration projects are framed as technical transfer work, but the real risk often sits in operations. A system may support billing, order flow, service delivery, reporting, or compliance obligations that are not obvious from the database alone. When those dependencies are not discovered early, the migration plan becomes a schedule without a risk-control model behind it.

Common failure points include:

  • poor visibility into integrations and downstream reports
  • duplicated, stale, or inconsistent master data
  • unrealistic cutover windows
  • no clear definition of what business continuity means at go-live
  • rollback plans that exist on paper but are not operationally usable

The lesson is simple: a migration plan should be designed around business continuity, not just data movement.

Define what cannot break before you design the move

The first planning step is to identify which workflows the business cannot afford to interrupt. That usually includes some combination of order processing, customer support, inventory, billing, staff operations, partner integrations, or regulatory reporting.

A practical way to start is to group workflows into three bands:

  • must not stop
  • can tolerate short delay
  • can be rebuilt or improved after cutover

This creates a more realistic planning model. It also prevents the team from over-migrating legacy complexity that no longer serves the business well.

Audit systems, data, and integrations before setting dates

Teams are often tempted to ask for a cutover date too early. A safer sequence is discovery first, timing second.

Discovery should cover:

  • source systems and data owners
  • application integrations and file transfers
  • reporting dependencies
  • user roles and permission requirements
  • compliance or retention obligations
  • data that should be migrated, archived, or retired

This is also the stage where data quality becomes a strategic decision. Not every record deserves migration. Some data should be cleaned, some should be archived, and some should be left behind deliberately. A migration without triage often carries legacy noise into the new system.

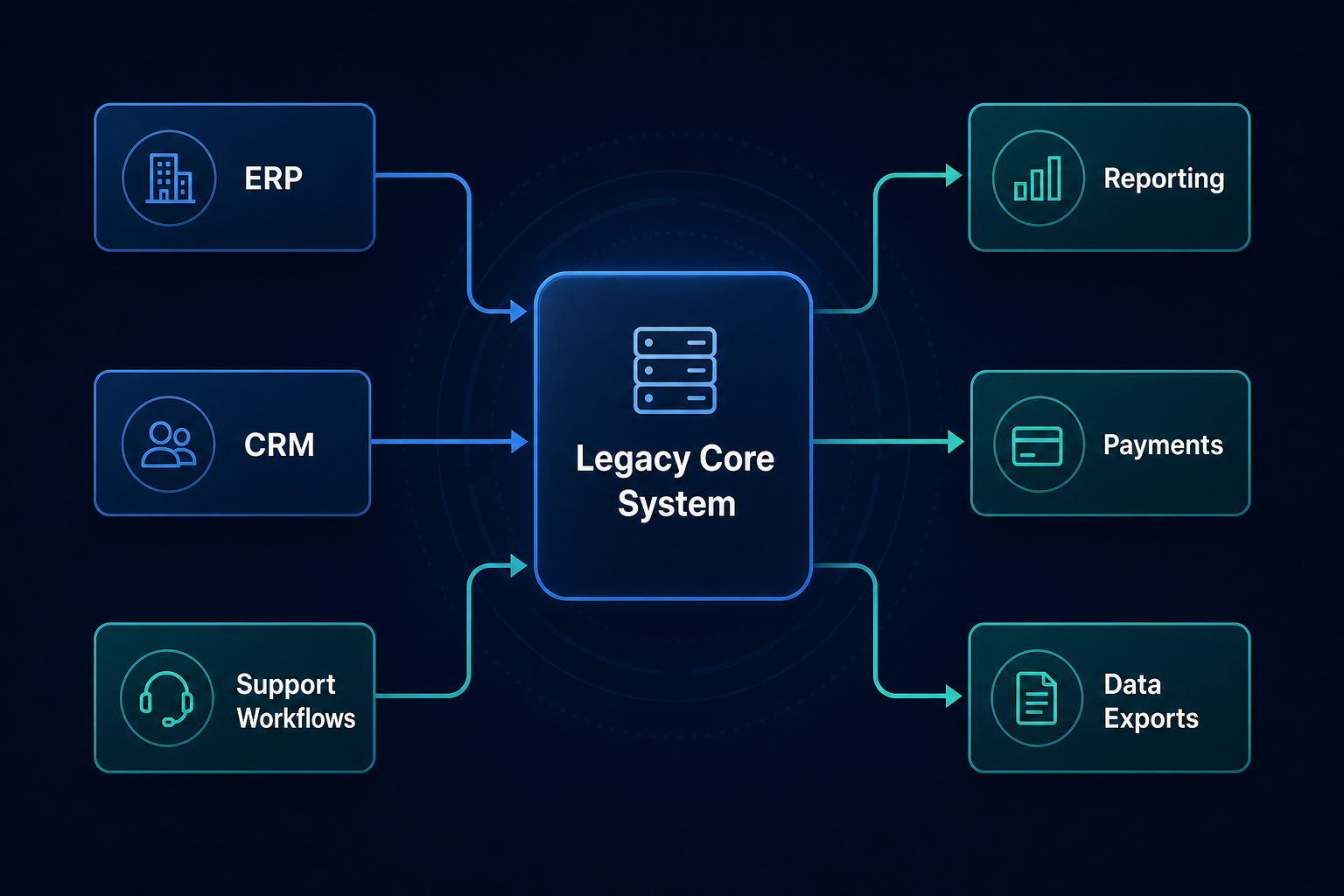

System dependency map showing a legacy core system connected to ERP, CRM, reporting, payments, and support workflows

Choose the right cutover pattern

A business-critical migration usually comes down to one of three patterns.

Big-bang migration

This can be faster when the system is relatively contained and the downtime window is acceptable. The trade-off is that the pressure on the cutover window is much higher.

Phased migration

This is useful when business units, workflows, or sites can move in stages. It reduces concentrated risk, but it often introduces temporary complexity because old and new processes must coexist for a period.

Parallel run

This is often the safest option for sensitive operations because the old and new systems can be compared side by side. The trade-off is cost and effort. Running two systems long enough to prove reliability is not lightweight.

The right pattern depends on downtime tolerance, integration complexity, regulatory exposure, and the business cost of failure.

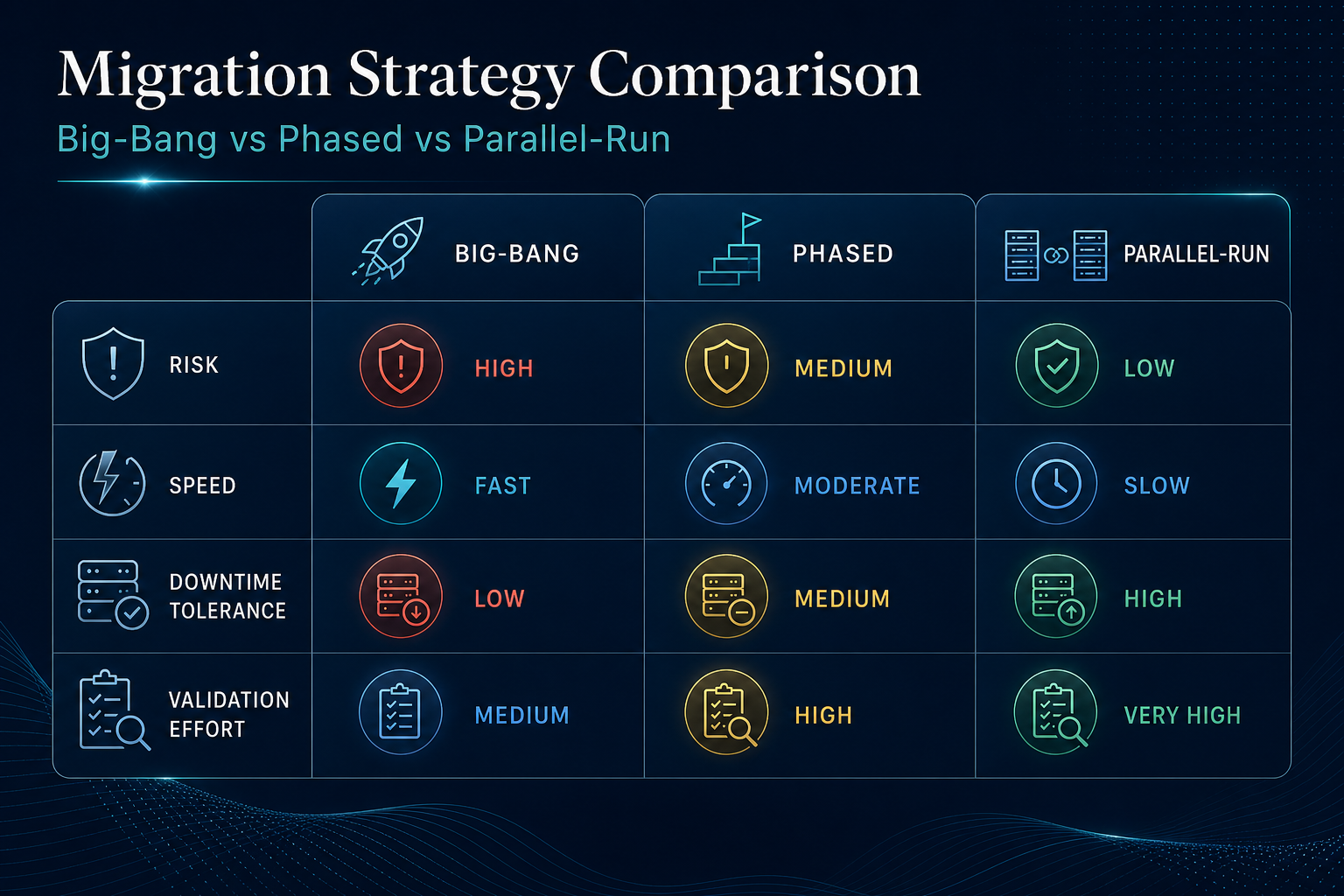

Decision framework comparing big-bang, phased, and parallel-run migration patterns

Build the cutover plan around validation and rollback

A good cutover plan is more than a go-live checklist. It should define:

  • the freeze window
  • the final data extract and import sequence
  • validation checkpoints
  • go or no-go decision owners
  • rollback triggers and time windows
  • communications during cutover and hypercare

Validation should include both technical and operational checks. Record counts matter, but so do real business scenarios such as order creation, invoice generation, user access, report generation, and downstream integrations.

Cutover runbook timeline with freeze window, final extract, validation gates, go-live, rollback window, and hypercare

Treat testing as operational proof

Testing should not end when a migration script completes successfully. For critical systems, testing needs to prove that the business can operate in the new environment under normal and exception conditions.

That usually means:

  • user acceptance testing based on real workflows
  • exception handling tests
  • permissions validation
  • reconciliation checks
  • peak-day or high-volume scenario testing where relevant

This is where experienced delivery partners reduce risk materially. They do not just test the transfer. They test the operating day that follows it.

Trade-offs leaders should discuss early

A safer migration path may cost more in the short term. Parallel validation, custom middleware, phased cutover support, and reconciliation tooling all add effort. But these investments often cost less than a failed go-live, emergency rollback, or broken operations window.

There is also a change-management trade-off. The business may need to simplify old workflows rather than replicate every legacy behaviour exactly. That can improve the future state, but only if those decisions are made deliberately.

When to bring in a migration partner

A migration partner becomes especially useful when the system touches revenue, compliance, customer experience, or several integrations. That is also where bespoke development may be required to bridge old and new systems, preserve reporting, or support phased transition workflows.

Virtualspirit can help businesses map dependencies, assess data quality, design safer cutover patterns, and build the integration work needed to keep operations running during the move.

CTA: Request a migration readiness assessment

If your team is planning a legacy-system move, the safest next step is to assess continuity risk before choosing a cutover path. Virtualspirit can help you identify hidden dependencies, sort data by business value, and design a practical plan for continuity, validation, and rollback.

Primary next step: Request a migration readiness assessment to review dependencies, cutover options, and rollback risk.

Secondary next step: Use the legacy system risk analyzer to surface transition risk before committing delivery scope.

FAQ

What is the biggest risk in a legacy system migration?

The biggest risk is usually not the transfer itself. It is undiscovered dependencies, poor data quality, or weak rollback planning that causes operational disruption after cutover.

Should every migration use a big-bang cutover?

No. Big-bang, phased, and parallel-run approaches each fit different downtime tolerances, integration complexity, and validation needs.

When should a company bring in a migration partner?

A migration partner is most useful when the system touches revenue, operations, compliance, or several integrations and the business needs a safer path than a simple export-import project.

Sources

  • Microsoft Cloud Adoption Framework: Plan your migration
  • Google Cloud: Migration to Google Cloud, Getting Started
  • AWS Prescriptive Guidance for Migration
  • NIST SP 800-34 Rev. 1 Contingency Planning Guide
  • UK NCSC: Decommissioning Legacy IT
  • NIST Cybersecurity Framework 2.0
FAQ

Understanding The Basics

What is the biggest risk in a legacy system migration?
The biggest risk is usually not the transfer itself. It is undiscovered dependencies, poor data quality, or weak rollback planning that causes operational disruption after cutover.
Should every migration use a big-bang cutover?
No. Big-bang, phased, and parallel-run approaches each fit different downtime tolerances, integration complexity, and validation needs.
When should a company bring in a migration partner?
A migration partner is most useful when the system touches revenue, operations, compliance, or several integrations and the business needs a safer path than a simple export-import project.
