Data Migration Cutover Checklist for Critical Operations Without Business Disruption
A data migration cutover should feel boring on the day it happens. If it feels dramatic, the team usually left too many decisions unresolved before the window opened.
Critical operations do not fail because one engineer forgot a command. They fail because the business, application, data, support, and rollback decisions were never turned into one operating plan.
Direct answer: A safe data migration cutover is a controlled business event, not a late-night database task. Before you move production data, you need a named system owner, a freeze plan, dependency checks, validation queries, rollback thresholds, user communication, and a command structure that can stop the release when evidence is weak. The practical goal is not zero anxiety. It is a cutover where every go, hold, or rollback decision is already defined before the clock starts.
For companies moving finance, service, operations, or customer data, the real risk is usually workflow breakage after the copy appears successful. That is why teams that need reliable data migration services should think about application handoffs, reconciliation, and business continuity as early as they think about rows and tables.
Why critical cutovers fail even when the data copy works
Most failed cutovers are not pure infrastructure incidents. The database may restore correctly while downstream work still breaks. A report runs against stale data. A service team cannot see the latest job status. Finance starts reconciling against the wrong numbers. Customer-facing systems show gaps because application jobs restarted in the wrong order.
That is why migration planning needs the same operational discipline discussed in API layer beats a full rewrite. The technical move is only one part of the risk surface. The bigger question is how dependent systems, people, and business decisions behave during the transition.

A good cutover plan also respects the same scoping discipline required when you scope an AI integration project without breaking operations. If the dependencies are unclear before go-live, the team will improvise under pressure. That is when downtime stretches, communications drift, and rollback becomes political instead of procedural.

What must be true before the freeze window starts
A strong cutover does not begin with copying data. It begins with proving that the team can stop change safely.
Before the freeze window, confirm these six foundations:
- System ownership is explicit. One person owns the final cutover call, but every major system and workflow also has a named decision-maker.
- The business freeze is real. Teams know what transactions, updates, imports, and exceptions must stop before extraction or sync begins.
- Validation logic already exists. Row counts, hash checks, financial totals, sample records, and workflow tests are prepared before the event.
- Rollback criteria are numeric. The team knows what failed threshold forces rollback instead of debate.
- Customer and internal communications are drafted. That includes service teams, finance, support, operations, and account managers.
- Dependent jobs are mapped in order. Interfaces, queues, caches, reports, scheduled jobs, and permissions resets are sequenced.
When these items are weak, teams usually compensate with longer cutover windows. That rarely solves the real issue. It simply gives the team more time to stay confused.

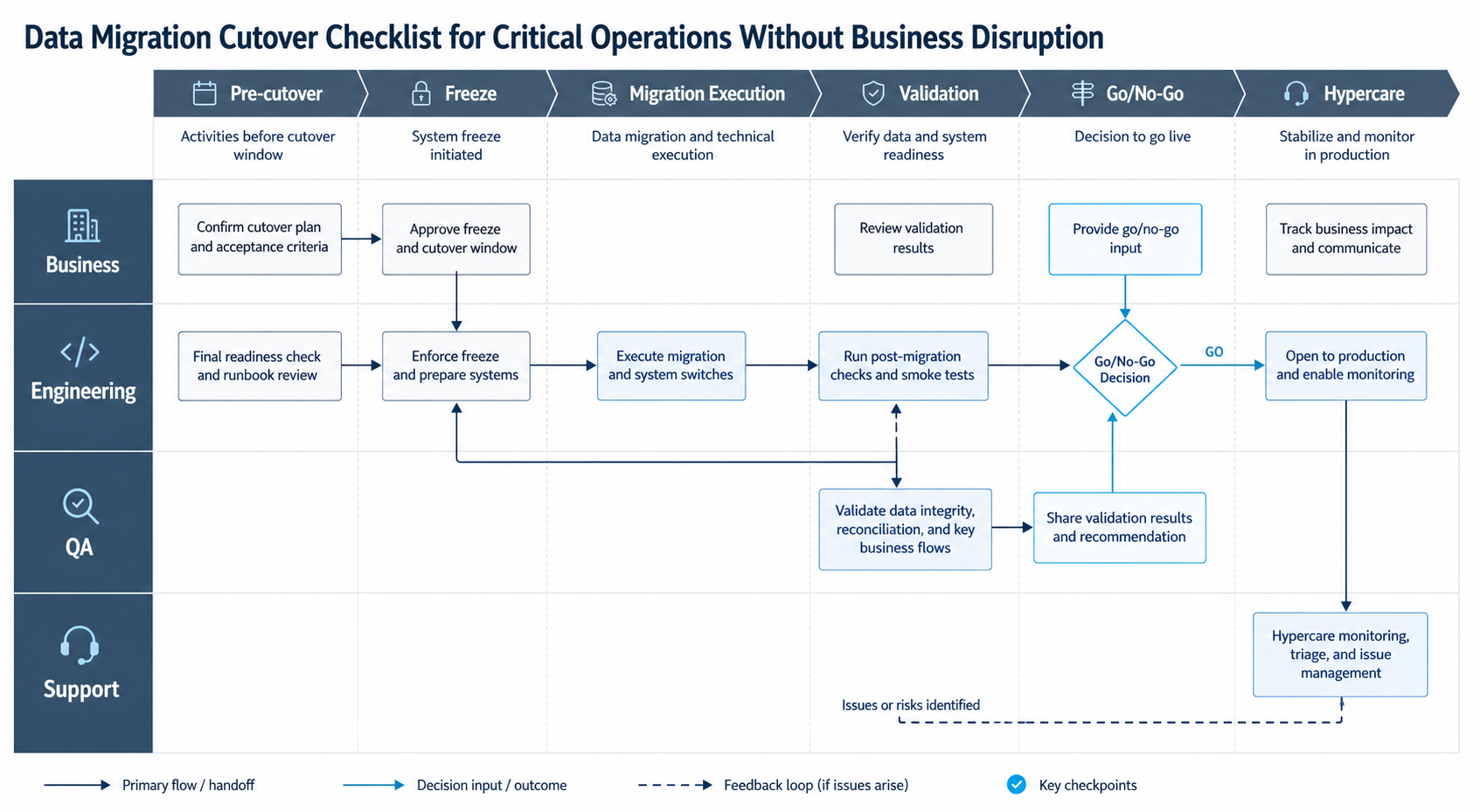

Build the cutover command structure before the cutover script
The best migration teams run the window like a command centre with clear lanes, not like a shared chat room. A practical structure usually includes:
- cutover lead for the final go, hold, and rollback decision,
- application lead for service behaviour and restart order,
- data lead for extraction, load, verification, and reconciliation,
- business validator for operational checks that matter outside engineering,
- support or comms lead for status updates and exception capture.

This matters because critical cutovers cross disciplines fast. Engineering may believe the migration is complete while operations still sees missing service events or finance sees unmatched balances. Without a command structure, those signals arrive out of order and the wrong team starts solving the wrong problem.
A capable bespoke development team will often help define this cross-functional runbook even when the technical migration tooling is already decided. That is where real business protection comes from: sequencing, ownership, and exception management.

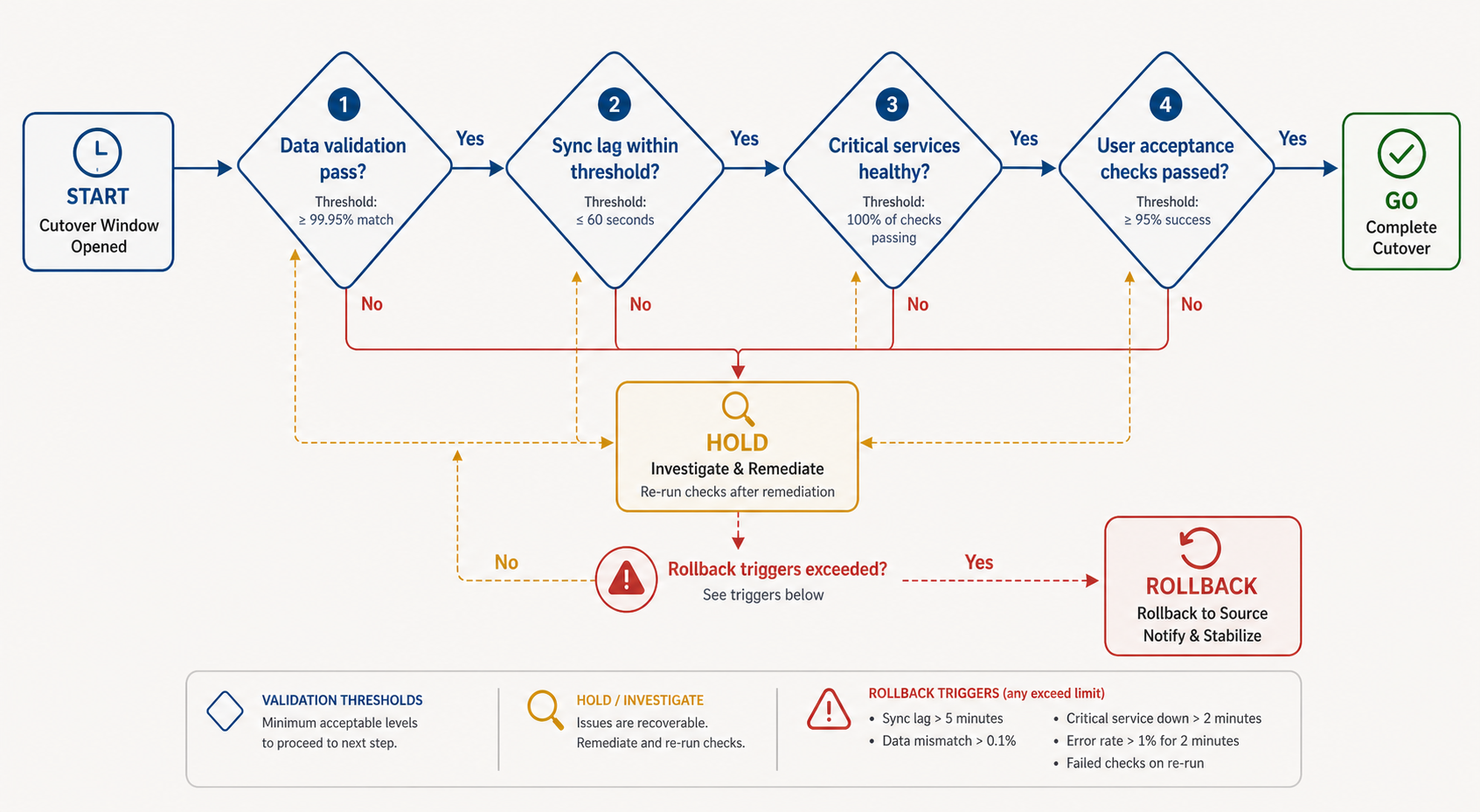

Decide rollback before go-live, not after anxiety rises
Many teams say they have a rollback plan when what they really have is a hopeful backup. A real rollback plan answers five operational questions in advance:
- What exact evidence says the new environment is unsafe?
- Who can trigger rollback without waiting for executive debate?
- How far can the team progress before rollback becomes more dangerous than staying forward?
- What data written during the cutover window needs isolation or replay handling?
- What message goes to users and teams if the rollback happens?

A clean rollback threshold keeps the team honest. For example, if critical reconciliation totals do not match within the allowed time, or if a priority workflow fails twice after recovery steps, rollback should be automatic. That is safer than stretching the incident while the business waits for certainty that never comes.
Rehearse the cutover like an operating event
A rehearsal is not just a timing estimate. It is where the team learns whether the runbook actually holds under pressure.
The rehearsal should test freeze timing, command channels, validation queries, escalation thresholds, and the clarity of the rollback call. It should also expose where business validators need simpler evidence or where technical steps depend on one person being awake and available. Those are exactly the kinds of hidden dependencies that create disruption later.
What to validate immediately after the data move
Post-cutover validation should move from highest business risk to lowest. A useful order is:
- authentication and permissions,
- core transaction creation and status updates,
- financial balances and high-value records,
- downstream integrations and scheduled jobs,
- customer-visible views and notifications,
- reporting and analytics.
Keep the validation list short enough to execute under time pressure, but sharp enough to catch the failure modes that would force rollback or service restrictions. A long checklist with weak prioritisation is less useful than a short checklist tied to real business consequence.
Common cutover mistakes that create business disruption
The most expensive mistakes usually sound reasonable before the event:
- assuming one successful lower-environment rehearsal proves production timing,
- letting business users keep entering exceptions during the freeze,
- validating technical completion without validating workflow completion,
- reopening the system before downstream queues and reports catch up,
- treating rollback as a leadership embarrassment instead of a planned control.
If the organisation wants a low-drama transition, the standard should be simple: every irreversible action must have a named owner, every critical check must have a threshold, and every workflow that could hurt customers or finance must be validated before the all-clear goes out.
Frequently Asked Questions
How long should a critical data migration cutover window be?
The window should be set by dependency order, rollback tolerance, and business validation time. Teams get into trouble when they start with a downtime target and then force the migration to fit it.
Should teams rehearse a cutover before production?
Yes. Rehearsals are where you learn whether the sequence, timings, validation queries, and ownership model actually work. A document review alone is not enough.
What is the biggest mistake in a migration cutover?
The biggest mistake is treating the cutover like a technical copy event instead of a business continuity event. Most disruption appears in workflows and handoffs, not only in the database itself.
Sources
- Google SRE Workbook: Disaster Recovery Planning
- AWS Prescriptive Guidance: Database Migration Strategy
- Microsoft Cloud Adoption Framework: Migrate
Primary CTA
If you need a production-safe migration plan, plan your cutover with Virtualspirit's data migration services.
Secondary CTA
If the migration also changes workflows, integrations, or operational tooling, see how Virtualspirit handles bespoke systems delivery.
